Apr 1, 2026 · 10:35 PM UTC
Artemis II
Space Launch System Block 1, Launch Complex 39B
National Aeronautics and Space Administration
NASA · Super heavy-lift
NASA’s Moon rocket. It launches Artemis astronauts in the Orion capsule.
The basics
The Space Launch System (SLS) is NASA’s heavy rocket for the Moon missions. It launches the capsule with astronauts aboard. Much of it is built from upgraded Space Shuttle parts, the same main engines and similar white side boosters.
Unlike Starship or New Glenn, SLS is not reusable: every rocket flies once. It has flown twice, both successfully, and the third is being assembled at Kennedy Space Center in Florida for Artemis III.
Words with a dotted underline anywhere on this page can be tapped for a quick definition.
Where it stands
Latest news · September 15, 2026
NASA's Shuttle-derived super heavy-lifter stands 98 meters tall and has flown twice. NASA cancelled Block 1B and Block 2 upgrades in February 2026 and is standardizing on the flying Block 1 vehicle. The is in the , with installation and booster underway for an Earth-orbit docking demo.
Source: NASA SLS overviewIts story so far
5 of 6 milestones done. The rocket for Artemis III is being assembled at Kennedy right now.
Green Run completeMar 2021
The fired all four engines together at Stennis for a full-duration eight-minute .
Done
Done

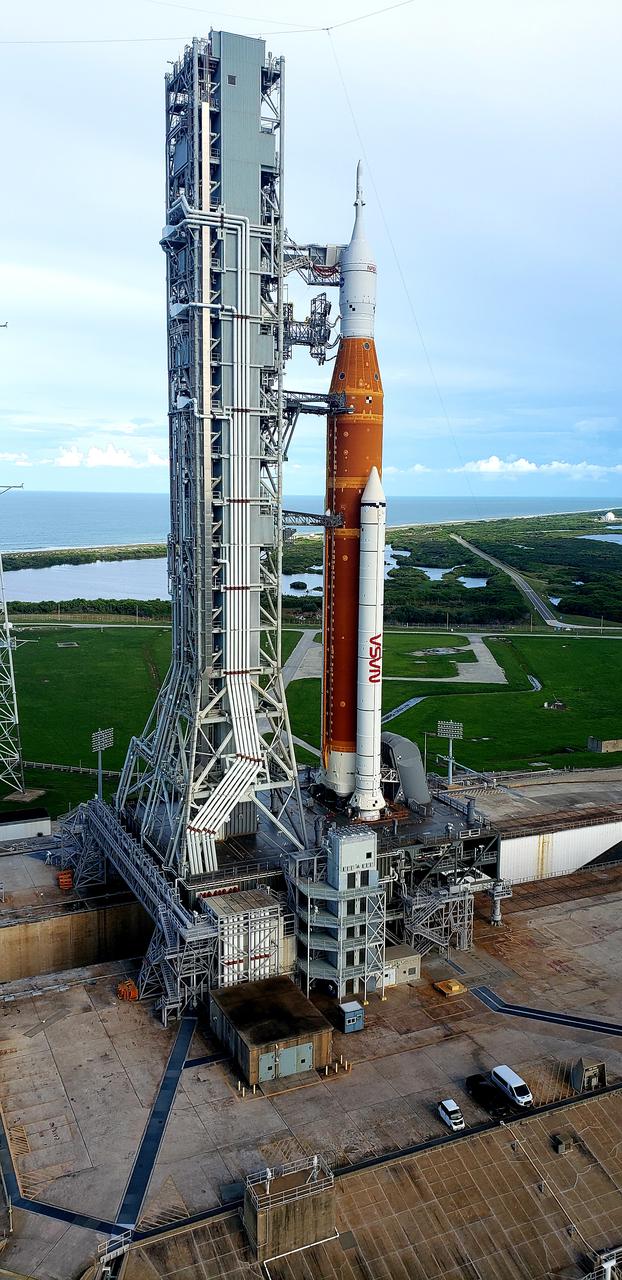

Stacked at LC 39BAug 2022
The 98-meter rocket rolled out and stood fully on pad for its first launch campaign.
Done
Done

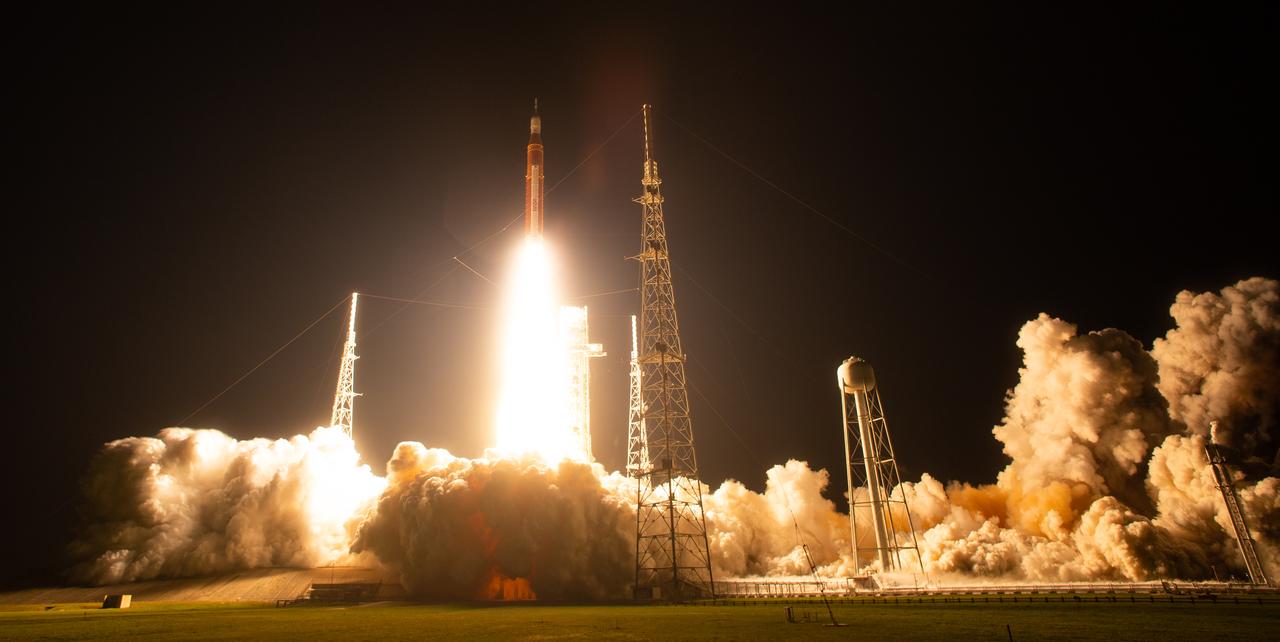

First flight, Artemis INov 16, 2022
SLS Block 1 lifted off on its debut, sending toward the Moon with margin to spare.
Done
Done

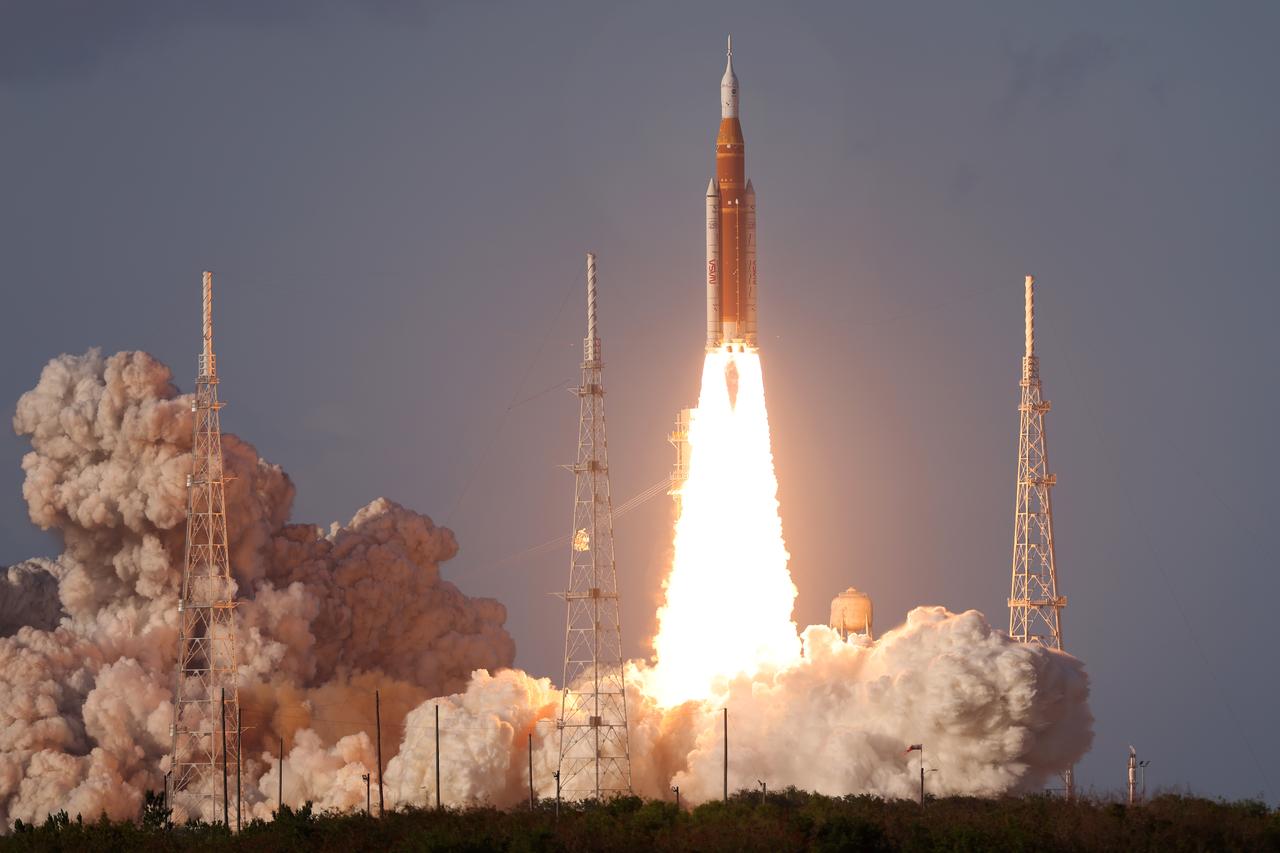

First crew, Artemis IIApr 1, 2026
The rocket's first crewed flight carried four astronauts around the Moon and back.
Done
Done
Artemis III core at KennedyNow
The next core is in the . RS-25 installation began August 24, and three of five were stacked as of August 31.
Happening now
Happening now
Block 1B cancelledFeb 2026
NASA cancelled the , Universal Stage Adapter, and Mobile Launcher 2 in February 2026.
Done
Done
In our launch catalog
SLS launches in our catalog. Tap one for its full launch page.
Configurations
SLS was meant to grow into bigger versions. NASA cancelled those upgrades in February 2026, so Block 1, the version that has already flown twice, is the only one going forward.
Flying
Cancelled
Cancelled
For enthusiasts
That’s the whole story. Everything below is the detail.
How each rocket is built and tested, our readiness signals for the next flight, and sources.
From factory to launch pad
Each SLS is built in pieces across the country and brought together at Kennedy Space Center in Florida. The Artemis III rocket is already there. The factory in New Orleans is building the next ones.
Core stage build: Michoud Assembly Facility
Friction-stir welding joins barrel sections into the 212-foot . The core left here in April 2026; later cores continue down this line.
Green Run (first article): Stennis Space Center
The Artemis I core fired all four engines on the B-2 stand. Later cores have not repeated that full-duration before shipping to Kennedy.
Booster casting: Northrop Grumman, Utah
solid motors are cast in pairs. Each booster produces about 3.6 million pounds of thrust at liftoff, not each segment.
Stack & launch ops: Kennedy Space Center
Booster is in the : three of five segments were up as of August 31, and RS-25 installation began August 24. Core mate, the spacer, and are still ahead of rollout to .
Our estimate
This is not a NASA launch probability. It scores public SLS production and test signals, Kennedy stacking, Michoud manufacturing, booster supply, and the cancelled Block 1B path, against what the next flight requires.
These are our own rough estimates from public evidence, not an official number and not a launch probability.
Core stage production
55%
III core in the VAB
The is in the . NASA began installing E2054, E2057, E2048, and E2052 on August 24 and has not posted that the install is finished. Michoud continues later cores; those articles are not the III .
RS-25 engine supply
50%
New engines in production
Flights draw from the 16 reused Shuttle-era RS-25Ds plus new-build RS-25E engines entering certification at Aerojet Rocketdyne.
Boosters
68%
3 of 5 segments stacked
Northrop Grumman said on August 31 that three of five Artemis III segments were stacked on the mobile launcher and the forward assemblies had been delivered. The crew viewed that integration on September 2. Each booster produces about 3.6 million pounds of thrust.
Green Run / stage testing
20%
First-article path only
The Artemis I core completed a full-duration Stennis in March 2021. Later cores, including Artemis III, have not repeated that campaign before shipping to Kennedy.
Block 1B evolution
30%
Cancelled Feb 2026
NASA cancelled the , Universal Stage Adapter, and Mobile Launcher 2. The agency is standardizing on Block 1.
Integrated launch campaign
18%
VAB stacking underway
and the core are in the VAB, and engine installation has started. and countdown rehearsals still wait on a complete stack and a committed launch period.
Where this comes from
The official records and reporting this page is built from. Readiness figures are our own estimates from public signals, not an official NASA number.
