Blue Origin · Cape Canaveral

New Glenn

Blue Origin’s reusable heavy rocket. It is grounded and rebuilding after a launch-pad explosion.

Start with the basicsThe road backOfficial recovery plan
New Glenn
BasicsRight nowRoad backFlightsMay 28InvestigationsLaunch setupDamageSources

The basics

What is New Glenn?

New Glenn is the big rocket from Blue Origin, the space company founded by Jeff Bezos. It launches from Cape Canaveral in Florida, and its booster is designed to land on a ship at sea so it can fly again.

It’s grounded right now. On its third flight, in April 2026, the upper stage underperformed and the satellite ended up in an too low to use. Then on May 28, 2026, a rocket exploded during an engine test on the pad, badly damaging it. Everyone on site was accounted for. This page tracks the repairs and the road back to flight.

Flights
3
Two delivered their payload as planned
Reusable
Booster
Lands on a ship at sea
Status
Grounded
Launch pad being rebuilt
Goal
Fly by end of 2026
Blue Origin’s target, not a launch date
Rocket words on this page, explained16 words▾

Words with a dotted underline anywhere on this page can be tapped for a quick definition.

Static fire
Firing the engines while the vehicle is clamped to the ground. It proves the engines work before the real flight.
Cryo test
Filling the tanks with super-cold liquid to check they hold pressure without leaking. It happens before engines go in.
Stack
Putting rocket pieces on top of one another so they form the full rocket. For Starship, it means lifting the ship onto the booster at the pad.
Orbit
Going fast enough (about 28,000 km/h or 17,500 mph) to keep falling around the Earth instead of back down. Reaching orbit is the big step from test hops to real missions.
FAA license
The U.S. Federal Aviation Administration has to approve each launch for public safety. No license, no launch.
Launch pad
The structure the rocket stands on at liftoff, with fuel lines and a tower beside it. Starbase has Pad 1 and Pad 2.
LEO
Low Earth orbit. It sits a few hundred kilometres up, where the International Space Station flies.
Anomaly
Industry wording for something going wrong. It can mean anything from a small fault to an explosion.
CONOPS
“Concept of operations”: the step-by-step plan for how a rocket is assembled, moved, and launched.
GS1 / GS2
New Glenn’s first stage (GS1, the reusable booster) and second stage (GS2, the part that reaches orbit).
BE-4
The engine on New Glenn’s first stage. Each booster has seven.
7x2 / 9x4
New Glenn versions named by engine count: 7 first-stage and 2 second-stage engines (flying today), or a larger 9-and-4 version planned later.
Launch complex
A launch pad plus its support buildings. Cape Canaveral’s are numbered. LC 36 is New Glenn’s, and LC 39B is SLS’s.
Transporter-erector
The machine that carries a rocket out to the pad lying down and tips it upright.
Integration Facility
The hangar where a rocket’s stages are joined together before it goes to the pad.
Never Tell Me The Odds
The name of a New Glenn booster. Blue Origin names its reusable boosters, the way ships get names.

Where it stands

Right now

Status
Grounded · Tower modules restacking
Road back
2 of 5 recovery steps done
Next flight
By end of 2026: Blue Origin’s goal, not a launch date

Latest news · September 15, 2026

New Glenn is still rebuilding LC for a crane-based return to flight. Refurbished vehicle-access-tower modules are going back up, is headed to the , and a new upper stage has shipped to Stennis. Blue Origin’s public goal is still a flight before the end of 2026, that is not a launch date.

Source: Orlando Sentinel · LC 36 rebuild

Blue Origin’s official plan

The road back to flight

Blue Origin has a five-step plan to fly again. 2 of 5 steps are done.

  1. Site secured

    LC 36 access and safety controls established after the May 28 .

    Done

    Done

  2. Recovery and cleanup

    Hardware recovery and debris removal are complete; reconstruction has started.

    Done

    Done

  3. 3

    CONOPS and major repairsSep 2026

    Refurbished vehicle-access-tower modules are being restacked for the crane-based flow. Launch-table inspection and the rest of the pad rebuild are still in work.

    Happening now

    Happening now

  4. 4

    Systems integration2026

    Repaired ground systems and the crane-based flow must be integrated and tested.

    Up next

    Up next

  5. 5

    Flight readinessTBD

    Corrective-action verification, mission assignment, rollout, rehearsal, range coordination, and a launch window remain ahead.

    Later

    Later

Every flight so far

Flights so far

New Glenn’s flights, newest first. These are separate from the May 28 explosion, which happened during a ground test.

  1. NG-3

    NG-3 / BlueBird 7

    Sunday, April 19, 2026

    Booster success / payload orbit failure

    The reused NG-2 booster landed again, but an upper-stage thrust anomaly left BlueBird 7 in an unusably low orbit; the spacecraft was subsequently deorbited.

  2. NG-2

    NG-2 / ESCAPADE

    Thursday, November 13, 2025

    Full mission success

    New Glenn deployed NASA's ESCAPADE twin spacecraft to their loiter orbit and landed the first stage on Jacklyn.

  3. NG-1

    NG-1

    Thursday, January 16, 2025

    Orbital success / booster lost

    New Glenn reached its intended orbit with Blue Ring Pathfinder; the first-stage landing attempt failed after a reentry-burn restart issue.

The pad explosion

What happened on May 28

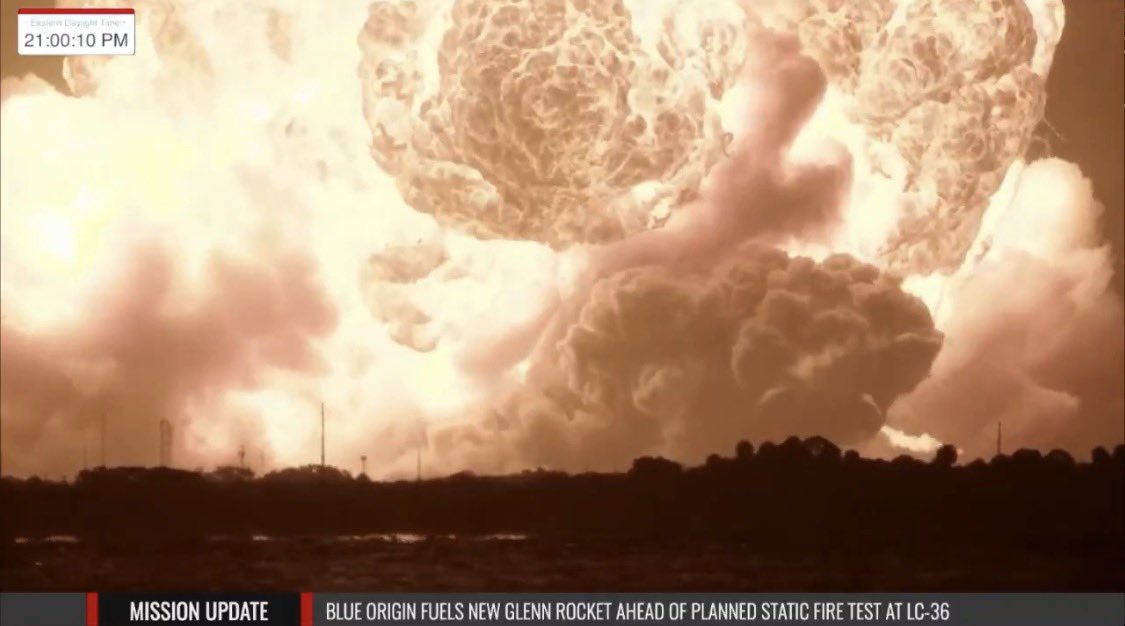

During an engine test on the launch pad, the rocket exploded and badly damaged the pad. Everyone on site was accounted for. The investigation is still open.

Watch the source footage from the May 28 integrated-vehicle hotfire anomaly, as captured from the Cape.

Watch source footage

For enthusiasts

That’s the whole story. Everything below is the detail.

The two investigations, how the rocket will now be set up on the pad, the confirmed damage, our readiness signals, and sources.

What went wrong

The two investigations

Two separate things went wrong in 2026, and each has its own investigation: the April flight that left a satellite in an unusable orbit, and the May 28 explosion on the launch pad.

Flight workstream

NG-3 corrective actions

The FAA closed the April 19 mishap investigation after identifying a cryogenic leak that froze a hydraulic line during the second-stage burn. Nine corrective actions still require verification before the next launch.
FAA return to flight authorized · verification pending

Ground workstream

May 28 hotfire investigation

The separate integrated-vehicle hotfire investigation remains active. On August 6 Dave Limp said the anomaly originated at the main oxygen valve on one BE-4 engine; remaining fault-tree work is still in progress. Recovery and cleanup are complete, and pad reconstruction has started.
Root cause under investigation · repairs in work

How it gets to the pad

A new way to get to the pad

The machine that used to carry New Glenn to the pad and tip it upright was destroyed. Instead of rebuilding it, Blue Origin will lift the rocket into place with a crane.

  1. 1

    Horizontal mate

    and GS2 are joined inside the .

  2. 2

    Roll to 36A

    The integrated vehicle travels to the refurbished pad.

  3. 3

    Vertical breakover

    A crane lifts New Glenn onto the and hold-down ring.

  4. 4

    Payload mate

    The payload is lifted and connected after the rocket is vertical.

Configuration continuity

New Glenn is not skipping directly to 9x4. 7x2 production continues at rate while the new launch flow is completed.

Return vehicle
7x2
Return pad
36A

What the pad kept and lost

What the pad kept and lost

The confirmed damage at the launch pad as of September 15, 2026, and the signals we watch for the next flight.

Preserved infrastructure
  • Tank farm
  • Integration Facility
  • Vehicle access tower
  • Water tower
In work
  • Launch table
  • Tower modules restacking
Lost hardware
  • Lightning tower
  • Transporter-erector
  • Hydraulic cylinders
Vehicle path
  • Never Tell Me The Odds, returning to the Integration Facility
Healthy in the Integration Facility as of June 1
  • Three GS2 stages

Signals we watch · 52% overall

These are our own rough estimates from public evidence, not an official number and not a launch probability.

  • Pad recovery

    64%

    Tower modules restacking

    Cleanup is complete. Earlier in September, refurbished vehicle-access-tower modules began going back onto the tower. The remains in inspection. Umbilical work, water-system tie-in, and systems integration are still ahead.

  • Hotfire investigation

    48%

    Valve identified · fault tree open

    On August 5 Dave Limp said the originated at the main oxygen valve on one , confirmed by recovered hardware. Valve modifications were in manufacturing and expected by the end of August. Blue Origin has not posted that the remaining fault tree is closed.

  • NG-3 flight actions

    68%

    Verification pending

    The closed the NG-3 mishap investigation and authorized return to flight, subject to verification of nine corrective actions and other licensing requirements.

  • Launch operations

    42%

    New flow in design

    The vehicle will be integrated horizontally, lifted onto the refurbished launch table by crane, and receive its payload after .

  • Next mission

    22%

    Assignment pending

    Blue Origin has not publicly confirmed the next payload, target , or launch window beyond its goal to fly again before the end of 2026.

  • Upper-stage testing

    68%

    Stage shipped to Stennis

    The July 24 Stennis agreement added an upper-stage site. In early September a new upper stage shipped from Florida to Stennis for that test. A completed hotfire has not been posted.

Where this comes from

Sources and updates

The official records and reporting this page is built from. Readiness figures are our own estimates from public signals, not an official Blue Origin number.

  • Blue Origin New Glenn
  • Blue Origin return-to-flight plan
  • Blue Origin launch-table recovery update
  • Blue Origin Stennis test-site agreement
  • Blue Origin news
  • Blue Origin hotfire updates
  • Blue Origin NG-3 mission
  • FAA NG-3 mishap statement
  • AST SpaceMobile BlueBird 7 statement
